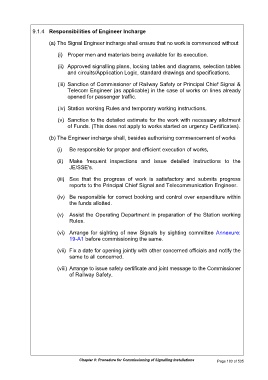

9.1.4  Responsibilities of Engineer Incharge

                       (a) The Signal Engineer incharge shall ensure that no work is commenced without

                           (i)  Proper men and materials being available for its execution.


                           (ii)  Approved signalling plans, locking tables and diagrams, selection tables
                               and circuits/Application Logic, standard drawings and specifications.

                           (iii)  Sanction of Commissioner of Railway Safety or Principal Chief Signal &
                               Telecom Engineer (as applicable) in the case of works on lines already
                               opened for passenger traffic.

                           (iv) Station working Rules and temporary working instructions.

                           (v)  Sanction to the detailed estimate for the work with necessary allotment
                               of Funds. (This does not apply to works started on urgency Certificates).

                       (b) The Engineer incharge shall, besides authorising commencement of works

                          (i)   Be responsible for proper and efficient execution of works,


                          (ii)  Make  frequent  inspections  and  issue  detailed  instructions  to  the
                                JE/SSE's.

                          (iii)  See  that  the  progress  of  work  is  satisfactory  and  submits  progress
                                reports to the Principal Chief Signal and Telecommunication Engineer.


                          (iv)  Be responsible for correct booking and control over expenditure within
                                the funds allotted.


                          (v)  Assist the Operating Department in preparation of the Station working
                                Rules.


                          (vi)  Arrange  for sighting  of  new  Signals  by  sighting  committee  Annexure:
                                19-A1 before commissioning the same.

                          (vii)  Fix a date for opening jointly with other concerned officials and notify the
                                same to all concerned.


                          (viii) Arrange to issue safety certificate and joint message to the Commissioner
                                of Railway Safety.
