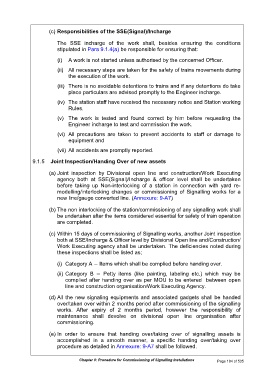

(c) Responsibilities of the SSE(Signal)/Incharge

                          The  SSE  incharge  of  the  work  shall,  besides  ensuring  the  conditions
                          stipulated in Para 9.1.4(a) be responsible for ensuring that:

                           (i)  A work is not started unless authorised by the concerned Officer.
                           (ii)  All necessary steps are taken for the safety of trains movements during
                               the execution of the work.

                           (iii)  There is no avoidable detentions to trains and if any detentions do take
                               place particulars are advised promptly to the Engineer incharge.
                           (iv)  The station staff have received the necessary notice and Station working
                               Rules.

                           (v)  The  work  is  tested  and  found  correct  by  him  before  requesting  the
                               Engineer incharge to test and commission the work.
                           (vi)  All  precautions  are  taken  to  prevent  accidents  to  staff  or  damage  to
                               equipment and

                           (vii)  All accidents are promptly reported.

               9.1.5   Joint Inspection/Handing Over of new assets

                       (a) Joint  inspection  by  Divisional  open  line  and  construction/Work  Executing
                          agency  both  at  SSE(Signal)/Incharge  &  officer  level  shall  be  undertaken
                          before  taking  up  Non-interlocking  of  a  station  in  connection  with  yard  re-
                          modelling/interlocking  changes  or  commissioning  of  Signalling  works  for  a
                          new line/gauge converted line. (Annexure: 9-A7)

                       (b) The non interlocking of the station/commissioning of any signalling work shall
                          be undertaken after the items considered essential for safety of train operation
                          are completed.

                       (c) Within 15 days of commissioning of Signalling works, another Joint inspection
                          both at SSE/Incharge & Officer level by Divisional Open line and/Construction/
                          Work Executing agency shall be undertaken. The deficiencies noted during
                          these inspections shall be listed as;

                          (i)  Category A − Items which shall be complied before handing over.

                          (ii) Category  B  −  Petty  items  (like  painting,  labeling  etc.)  which  may  be
                              complied after handing over as per MOU to be entered  between open
                              line and construction organisation/Work Executing Agency.


                       (d) All the new signaling equipments and associated gadgets shall be handed
                          over/taken over within 2 months period after commissioning of the signalling
                          works.  After  expiry  of  2  months  period,  however  the  responsibility  of
                          maintenance  shall  devolve  on  divisional  open  line  organisation  after
                          commissioning.


                       (e) In  order  to  ensure  that  handing  over/taking  over  of  signalling  assets  is
                          accomplished  in  a  smooth  manner,  a  specific  handing  over/taking  over
                          procedure as detailed in Annexure: 9-A7 shall be followed.
