Page 237 - IRSEM_Main Book
P. 237

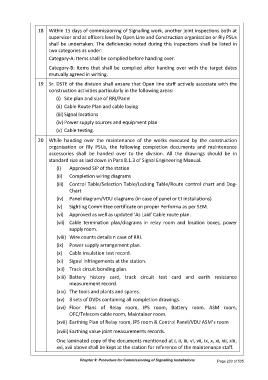

18  Within 15 days of commissioning of Signalling work, another joint inspections both at
                       supervisor and at officers level by Open Line and Construction organisation or Rly PSUs
                       shall be undertaken. The deficiencies noted during this inspections shall be listed in
                       two categories as under:
                       Category-A: Items shall be complied before handing over.

                       Category-B: Items that shall be complied after handing over with the target dates
                       mutually agreed in writing.
                  19  Sr. DSTE of the division shall ensure that Open line staff actively associate with the
                       construction activities particularly in the following areas:
                          (i)  Site plan and size of RRI/Panel
                          (ii) Cable Route Plan and cable laying

                          (iii) Signal locations
                          (iv) Power supply sources and equipment plan
                          (v) Cable testing.

                  20  While  handing  over  the  maintenance  of  the  works  executed  by  the  construction
                       organisation  or  Rly  PSUs,  the  following  completion  documents  and  maintenance
                       accessories  shall  be  handed  over  to  the  division.  All  the  drawings  should  be  in
                       standard size as laid down in Para 8.1.3 of Signal Engineering Manual.

                          (i)   Approved SIP of the station
                          (ii)   Completion wiring diagrams
                          (iii)  Control Table/Selection Table/Locking Table/Route control chart and Dog-
                                Chart
                          (iv)  Panel diagram/VDU diagrams (in case of panel or EI installations)
                          (v)   Sighting Committee certificate on proper Performa as per SEM.
                          (vi)  Approved as well as updated ‘As Laid’ Cable route plan.

                          (vii)  Cable  termination  plan/diagrams  in  relay  room  and  location  boxes,  power
                                supply room.

                          (viii)  Wire counts details n case of RRI.
                          (ix)  Power supply arrangement plan.
                          (x)   Cable insulation test record.
                          (xi)  Signal infringements at the station.

                          (xii)  Track circuit bonding plan.
                          (xiii)  Battery  history  card,  track  circuit  test  card  and  earth  resistance
                                measurement record.
                          (xiv)  The tools and plants and spares.
                          (xv)  3 sets of DVDs containing all completion drawings.
                          (xvi)  Floor  Plans  of  Relay  room,  IPS  room,  Battery  room,  ASM  room,
                                OFC/Telecom cable room, Maintainer room.
                          (xvii) Earthing Plan of Relay room, IPS room & Control Panel/VDU ASM’s room

                          (xviii) Earthing value joint measurements records.
                          One laminated copy of the documents mentioned at i, ii, iii, vi, vii, ix, x, xi, xii, xiii,
                          xvi, xvii above shall be kept at the station for reference of the maintenance staff.


                                    Chapter 9: Procedure for Commissioning of Signalling Installations   Page 203 of 535
