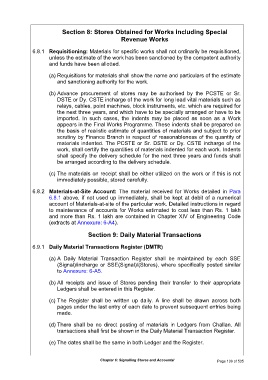

Page 137 - IRSEM_Main Book
P. 137

Section 8: Stores Obtained for Works including Special

                                                       Revenue Works

               6.8.1  Requisitioning: Materials for specific works shall not ordinarily be requisitioned,
                       unless the estimate of the work has been sanctioned by the competent authority
                       and funds have been allotted.

                       (a) Requisitions for materials shall show the name and particulars of the estimate
                          and sanctioning authority for the work.

                       (b) Advance  procurement  of  stores  may  be  authorised  by  the  PCSTE  or  Sr.
                          DSTE or Dy. CSTE incharge of the work for long lead vital materials such as
                          relays, cables, point machines, block instruments, etc. which are required for
                          the next three years, and which have to be specially arranged or have to be
                          imported.  In  such  cases,  the  indents  may  be  placed  as  soon  as  a  Work
                          appears in the Final Works Programme. These indents shall be prepared on
                          the basis of realistic estimate of quantities of materials and subject to prior
                          scrutiny by Finance Branch in respect of reasonableness of the quantity of
                          materials indented. The PCSTE or Sr. DSTE or Dy. CSTE incharge of the
                          work, shall certify the quantities of materials indented for each work. Indents
                          shall specify the delivery schedule for the next three years and funds shall
                          be arranged according to the delivery schedule.

                       (c) The materials on receipt shall be either utilized on the work or if this is not
                          immediately possible, stored carefully.

               6.8.2  Materials-at-Site  Account:  The  material  received  for Works  detailed  in  Para
                       6.8.1 above, if not used up immediately, shall be kept at debit of a numerical
                       account of Materials-at-site of the particular work. Detailed instructions in regard
                       to maintenance of accounts for Works estimated to cost less than Rs. 1 lakh
                       and more than Rs. 1 lakh are contained in Chapter XIV of Engineering Code
                       (extracts at Annexure: 6-A4).

                                        Section 9: Daily Material Transactions


               6.9.1  Daily Material Transactions Register (DMTR)

                       (a) A  Daily  Material  Transaction  Register  shall  be  maintained  by  each  SSE
                          (Signal)/incharge or SSE(Signal)/(Stores), where specifically posted similar
                          to Annexure: 6-A5.

                       (b) All  receipts  and  issue  of  Stores  pending  their  transfer  to  their  appropriate
                          Ledgers shall be entered in this Register.

                       (c) The  Register  shall  be  written  up  daily.  A  line  shall  be  drawn  across  both
                          pages under the last entry of each date to prevent subsequent entries being
                          made.

                       (d) There  shall  be  no  direct  posting  of  materials  in  Ledgers  from  Challan.  All
                          transactions shall first be shown in the Daily Material Transaction Register.

                       (e) The dates shall be the same in both Ledger and the Register.
